SPK-02

Schedule-Index Coupling

The Sentinel ICBM program's 2024 critical Nunn-McCurdy breach occurred despite modern schedule management tools. The enforcement infrastructure exists—IPMDAR schema validation, DCMA's 140+ compliance metrics, Performance Based Payments, DFARS withholds. What does not exist is a Sentinel-specific conformance specification ensuring the re-baselined IMS encodes the physical dependencies the 2020 baseline omitted. SI-CK provides that specification: a validation layer that makes schedule dependencies computationally verifiable against engineering reality.

doi:10.5281/zenodo.18933118

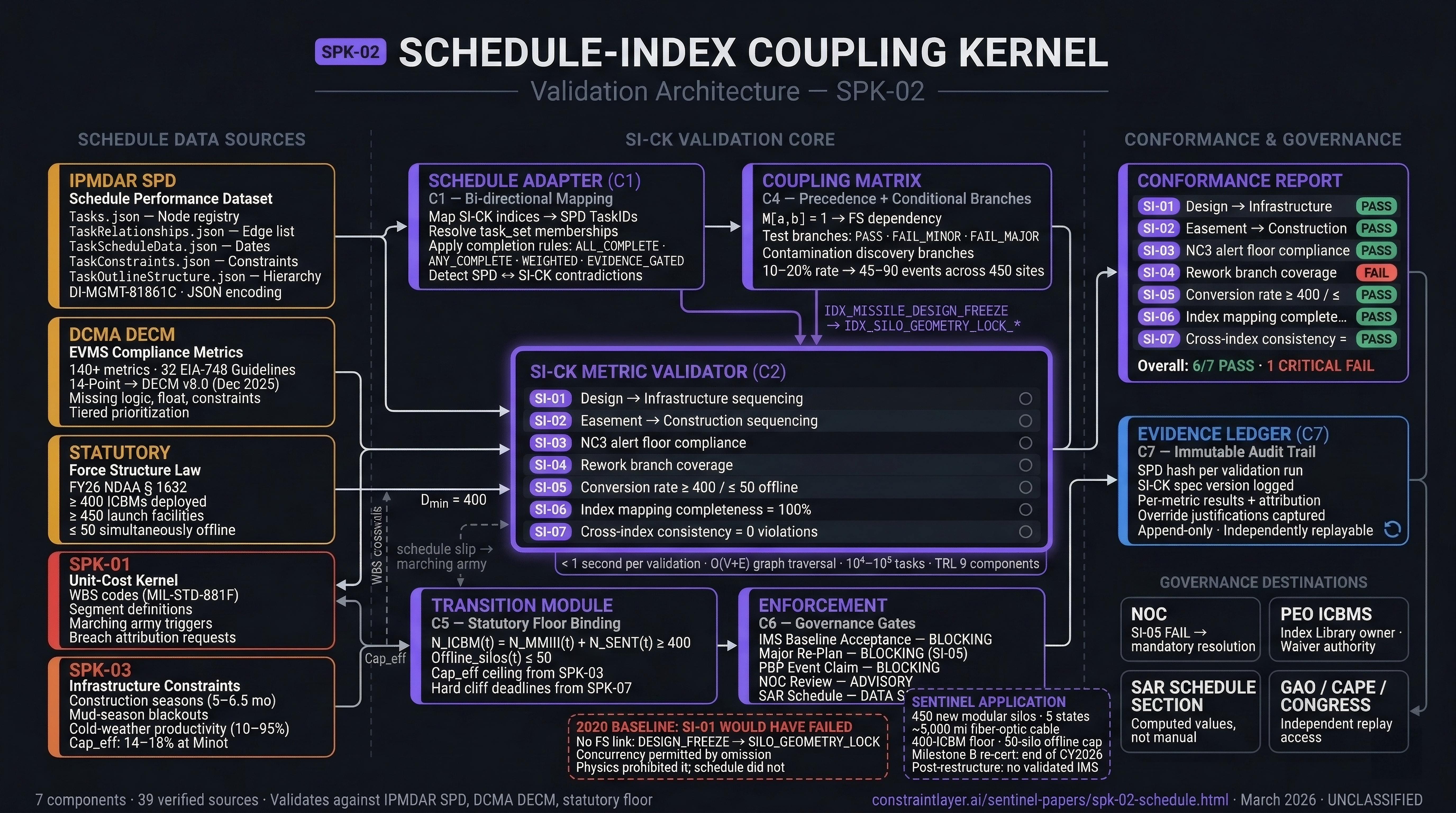

SI-CK validation architecture. Schedule data flows from existing DoD systems (IPMDAR SPD, DCMA DECM, statutory framework) through the SI-CK validation core (Schedule Adapter, Sentinel Index Library, Coupling Matrix, Metric Validator) to produce conformance reports with full evidence ledger audit trail for NOC, PEO ICBMs, and congressional oversight.
0

The Bottom Line

The Schedule-Index Coupling Kernel (SI-CK) is SPK-02 of the Sentinel Recovery Architecture. It is not a new scheduling tool, not a new enforcement mechanism, and not a replacement for existing governance. IPMDAR schema validation rejects malformed schedule data at upload.[9] DCMA's 140+ EVMS Compliance Metrics (DECM) detect logic flaws algorithmically.[10] Performance Based Payments gate contractor cash flow on milestone completion.[11] DFARS 252.242-7005 authorizes payment withholds for business system deficiencies.[12]

What does not exist is a Sentinel-specific conformance specification that ensures the program's re-baselined Integrated Master Schedule encodes the physical and programmatic dependencies the 2020 baseline omitted.

The 2024 Breach: Program Acquisition Unit Cost grew 81%, from $118 million to $214 million per unit across 659 units, driving total acquisition cost from $95.8 billion (then-year baseline)[33] to $140.9 billion (then-year current).[1][2][3] The Department's root cause analysis cited "ineffective systems engineering and incomplete basic system design" at Milestone B.[5]

In February 2026, the Air Force announced the restructured program: 450 new modular silos, approximately 5,000 miles of fiber-optic cable, across 32,000 square miles in five states. A prototype silo broke ground at Promontory, Utah on February 13, 2026.[7] Milestone B re-certification is expected by end of calendar year 2026; IOC is targeted for the "early 2030s."[8]

The GAO found that the program's master schedule had "many deficiencies" and was under review.[4] Post-restructuring, the program operates without a validated lifecycle IMS while developing a new acquisition baseline.

SI-CK targets two closure mechanisms:

  • MC2 (Schedule Computability): Schedule status must be computationally determinable from source data, not narratively asserted.
  • PE2 (Dependency Transparency): All schedule assertions reduce to index shifts and gate completion, not narrative.
PE2 in Practice: The statement “IOC slipped 18 months” becomes: IDX_FIRST_FLIGHT_OPERATIONAL delayed from t₁ to t₂ because predecessors IDX_SILO_GEOMETRY_LOCK_WARREN and IDX_NC3_FIBER_OVERLAY_SEGMENT_A remained incomplete at t₁, with rework loop IDX_INTEGRATION_TEST_FAILURE_PATH active. Every schedule assertion maps to indices, predecessors, and conditional branches—not narrative.
What SI-CK Is Not: SI-CK does not replace DCMA, build a new scheduling tool, or create new enforcement infrastructure. Specifically:
Not a new enforcement mechanism. IPMDAR, DCMA DECM, PBP, and DFARS 252.242-7005 already provide schema validation, algorithmic detection, financial gates, and payment withholds. SI-CK provides Sentinel-specific conformance rules that these mechanisms enforce.
Not a new rework modeling methodology. Conditional branching and probabilistic rework modeling are established practice per the JA CSRUH. SI-CK mandates correct application of existing SRA standards to Sentinel’s specific test and integration sequences.
Not a schedule estimation system. SI-CK measures schedule logic validity and execution status. It does not estimate durations or predict completion dates.
Not a breach prevention system. SI-CK cannot prevent schedule slips caused by technical failure, funding instability, or requirements changes. It ensures that slips are measured consistently, attributed accurately, and propagated correctly through the dependency network.
The Window Is Closing: Milestone B re-certification is expected by end of calendar year 2026.[8] SI-CK must be established before the new IMS is built. Once a new baseline is accepted without SI-CK conformance requirements, the opportunity to embed physical dependency validation closes—and does not reopen until the next breach.
1

The Schedule Governance Challenge

Defense acquisition schedules present a paradox. They are simultaneously highly structured—thousands of tasks with explicit predecessors, successors, durations, and resource assignments—and fundamentally unreliable as predictive instruments. The structural integrity of a schedule can be perfect while its content validity is absent. A schedule passes every syntax check, every metric threshold, every compliance gate—and still fails to represent the physics of the program it purports to model.

Modern schedule management possesses substantial capability:

IPMDAR Schedule Performance Dataset (SPD): The DoD's transition from legacy XML-based IPMR to JSON-structured data exchange—completed with the release of DI-MGMT-81861B in March 2020 and updated to DI-MGMT-81861C in August 2021—transforms the IMS from a document into a queryable database.[9][18] The SPD explicitly encodes the schedule as a directed graph through TaskRelationships.json, with fields for PredecessorTaskID, SuccessorTaskID, RelationshipTypeID (1=FS, 2=SS, 3=FF, 4=SF), Lag, and LagCalendarID.[19]
DCMA EVMS Compliance Metrics (DECM): The DCMA's 14-Point Schedule Health Assessment, introduced in 2005, evolved into the DECM framework between 2016 and 2019, expanding from 14 schedule-specific tests to over 140 metrics covering all 32 EIA-748 Guidelines.[10][20] DECM version 8.0, released December 2025, introduced tiered prioritization distinguishing critical metrics from informational indicators.[21]
Joint Confidence Level (JCL) Analysis: The Joint Agency Cost Schedule Risk and Uncertainty Handbook (JA CSRUH), published in 2014 by the Naval Center for Cost Analysis and Air Force Cost Analysis Agency, prescribes probabilistic branching for discrete risk events like test failures, capturing rework loops that deterministic schedules ignore.[22]
Performance Based Payments (PBP): DFARS Subpart 232.10 ties contractor cash flow to objective milestone achievement. If the IMS logic shows a predecessor incomplete, the milestone event cannot be claimed—the schedule computation gates the payment.[11]
DFARS 252.242-7005: When contractor business systems have significant deficiencies, contracting officers can withhold 5% of payments for one deficiency, up to a maximum of 10% for two or more. The six covered systems are: Accounting, Earned Value Management, Estimating, Material Management and Accounting, Property Management, and Purchasing.[12]

The enforcement infrastructure exists. What it enforces is whatever the program chooses to encode. A program can submit IPMDAR-compliant JSON, pass DCMA metric thresholds, and still harbor a schedule that does not reflect engineering reality—because the dependencies were never specified.

2

Historical Evidence: Schedule Failures

The gap between schedule capability and schedule content has produced documented failures across major programs.

F-35 Joint Strike Fighter

GAO-14-322 (March 2014) found that challenges in developing and testing mission systems software—including software delivery delays, limited capabilities upon delivery, and the need to retest multiple versions—risked delaying expected warfighting capabilities by as much as 13 months.[23]

GAO-15-364 (April 2015) found that Block 3F software was delayed and constituted a "significant risk area," with delays in preceding blocks forcing reallocation of personnel from Block 3F development. Aircraft were being delivered with immature software, creating concurrency risk where the Department continued buying hardware while the software controlling it remained in development.[24]

The most direct finding came in GAO-21-105282 (July 2021), synthesizing findings from GAO-21-226: the F-35 Block 4 modernization program lacked a "knowledge-based schedule" and did not have a "fully logic-driven schedule" with established dependencies between activities, preventing accurate prediction of completion dates or assessment of delay impacts.[25]

KC-46 Tanker

GAO-12-366 (March 2012) found that the KC-46 schedule was "success-oriented" and allowed for "little, if any, schedule slip"—meaning any technical challenge would immediately cause delivery delays.[26]

GAO-15-308 (April 2015) found that Boeing's flight test plan was based on "optimistic" assumptions that did not adequately account for rework, retesting, or the correction of deficiencies found during testing.[27]

GAO-19-480 (June 2019) documented the consequences: the program was nearly three years behind schedule. The Remote Vision System (RVS) had critical deficiencies in lighting and image distortion. Rather than resolving deficiencies before delivery, the Air Force began accepting aircraft with known critical deficiencies in January 2019, planning to develop fixes and retrofit approximately 106 aircraft over several years.[28]

Common Thread: In each case, the IMS existed and contained thousands of tasks. The IMS passed structural validation. The IMS failed to encode physical dependencies that actually governed execution. Delays accumulated in ways the schedule could not predict or represent. Oversight received nominal schedule status while reality diverged.
3

The Sentinel Case

The LGM-35A Sentinel program entered Engineering and Manufacturing Development in September 2020 with a $13.3 billion contract to Northrop Grumman.[29][30] The acquisition strategy assumed significant reuse of existing Minuteman III infrastructure—silos, launch control centers, and copper cabling.[6]

In January 2024, the Air Force notified Congress that Sentinel had triggered a critical Nunn-McCurdy breach.[31] Following the Department's review, announced July 8, 2024:[1]

PAUC Growth: 81%, from $118M to $214M per unit across 659 units (400 deployed missiles plus 259 for testing and spares). Note: PAUC is quantity-sensitive. If the 659-unit production objective is adjusted during restructuring, per-unit cost figures change accordingly.[1][2]

Total Acquisition Cost: $95.8 billion (then-year baseline) to $140.9 billion (then-year current).[1][2]

Root Cause: Command and Launch Segment—civil infrastructure—was the primary driver. Roughly 80% of cost growth originated in ground infrastructure, real estate, and fiber-optic communications rather than the missile airframe.[1][3]

The cost explosion occurred because the original acquisition strategy assumed refurbishment of existing Minuteman III silos. A pilot conversion at Vandenberg Space Force Base revealed "unknown site conditions" posing "unacceptable risks to cost, schedule and weapon system performance."[6] Sentinel is confirmed as larger than Minuteman III, and the size differential necessitates different bore diameter and maintenance access configurations than 1960s-era silos can accommodate.[7][32]

Cost Baseline Reconciliation: Three Figures

Three figures circulate in public reporting. They represent different measurements of the same program:

$77.7 billion: Original September 2020 Milestone B baseline in Base-Year 2020 dollars.[3]

$95.8 billion: The same baseline in Then-Year dollars, accounting for projected inflation. This is the correct figure for Nunn-McCurdy breach calculation.[33]

$140.9 billion: Revised total acquisition cost in Then-Year dollars, announced July 8, 2024.[1]

Comparing $77.7 billion (BY2020) directly to $140.9 billion (TY) is invalid—it crosses dollar-year bases. The correct then-year comparison is $95.8 billion to $140.9 billion. As of March 2026, no new cost estimate reflecting the February 2026 restructure has been published.[2]

The Missing Dependency

The Department cited "ineffective systems engineering and incomplete basic system design" at the time of the Milestone B award.[5] The 2020 baseline embedded concurrent design and construction without encoding the physical constraint that launch facility specifications depend on missile design maturity. Sentinel's larger dimensions, shock isolation requirements, and maintenance access patterns dictate silo specifications.[6][7]

SI-CK's Analytical Inference (not an attributed finding): If the Sentinel IMS had contained: IDX_MISSILE_DESIGN_FREEZE → IDX_SILO_GEOMETRY_LOCK — then the schedule would have shown that construction planning for silos could not begin until missile design was complete. The "concurrent" approach would have registered as a constraint violation. No such relationship existed. The physics prohibited concurrency; the schedule did not.

No official source uses the specific formulation "silo geometry cannot be finalized until missile design freeze." The official root cause language is "ineffective systems engineering and incomplete basic system design."[5]
Counterfactual: The Validation Run That Would Have Rejected the 2020 Baseline. SI-CK’s SI-01 metric checks for a Finish-to-Start relationship between IDX_MISSILE_DESIGN_FREEZE and all IDX_SILO_GEOMETRY_LOCK_* nodes. The 2020 IMS contained no such relationship—silo construction planning proceeded concurrently with missile design maturation, with no encoded dependency between them. SI-01: FAIL. Baseline rejected. The enforcement mechanisms were present. The conformance rule that would have triggered them was not.

The February 2026 Restructure

Following the July 2024 certification, Milestone B approval was rescinded. In February 2026, the Air Force announced the restructured program:[7][8]

  • 450 new modular silos (not refurbishment of legacy silos)
  • Approximately 5,000 miles of fiber-optic cable (reduced from ~7,500–8,000 miles pre-restructure)
  • 24 launch centers, 3 missile wing command centers
  • 32,000 square miles across five states
  • Prototype silo broke ground February 13, 2026 at Promontory, Utah
  • Utility corridor prototyping scheduled for summer 2026 at F.E. Warren AFB
  • Milestone B re-certification expected by end of calendar year 2026
  • Test launch planned 2027
  • IOC target: "early 2030s"
  • No new cost estimate published yet
  • 659-unit production objective remains but may be adjusted

Officials stated that new construction "should be faster and less expensive because the new silos are modular and the work will not need to be done on silos that are currently being used."[7] No demonstrated production rates exist for either the modular silo methodology or the corridor construction approach.[7][32]

4

The IPMDAR Schedule Data Structure

SI-CK operates on existing data infrastructure. The IPMDAR, governed by Data Item Description DI-MGMT-81861C (approved August 30, 2021), replaced the legacy IPMR with a data-centric exchange standard requiring JSON encoding.[9][18] The transition from XML to JSON was completed with DI-MGMT-81861B in March 2020.[18]

The IPMDAR comprises three components: the Contract Performance Dataset (CPD) for cost, budget, and labor data; the Schedule Performance Dataset (SPD) for IMS network logic, task attributes, and resource assignments; and the Performance Narrative Report for contextual analysis.[9]

SPD File Structure: The Five JSON Files

The SPD File Format Specification and Data Exchange Instructions are publicly available from the OUSD(A&S) Acquisition Data and Analytics website.[19][34]

Tasks.json (Node Registry): Each activity in the IMS is represented as an object. Key fields include ID (unique persistent identifier), Name (descriptive title), and WBSElementID (foreign key to WBS structure, linking to UC-BCK cost elements).[19]

TaskScheduleData.json: Date and duration fields: TaskID (foreign key to Tasks.json), BaselineStartDate, BaselineFinishDate, ActualStartDate, ActualFinishDate, RemainingDuration (working days), PercentComplete (0–100).[19]

TaskConstraints.json: Constraint data using ConstraintTypeID (numeric enumeration covering ASAP, ALAP, SNET, SNLT, FNET, FNLT, MSO, MFO).[19]

TaskRelationships.json (Edge List): Dependencies encoded as directed edges: PredecessorTaskID (source node), SuccessorTaskID (target node), RelationshipTypeID (1=FS, 2=SS, 3=FF, 4=SF), Lag (duration), and LagCalendarID.[19]

TaskOutlineStructure.json (Hierarchy): Summary task relationships (parent-child) with TaskID, ParentTaskID, and OutlineLevel. This separation allows SI-CK to query logic (who drives whom) independently of reporting hierarchy (who rolls up to whom).[19]

When a contractor uploads IPMDAR JSON to the EVM Central Repository, automated validation scripts execute. Files failing validation are rejected—not "received with warnings" but technically non-delivered under the CDRL.[9]

Structural validation checks include: unique primary keys, referential integrity for foreign keys, ISO 8601 date compliance, controlled vocabulary for enumerated fields, non-null constraints on required fields, and directed acyclicity in the relationship graph.[19]

What Schema Validation Does NOT Check:
• Whether encoded dependencies reflect engineering reality
• Whether all physically necessary dependencies are present
• Whether durations are realistic
• Whether the critical path represents actual program risk

This is the gap SI-CK addresses: content validity beyond structural validity.
5

DCMA Compliance Metrics & Enforcement

The DCMA introduced the 14-Point Schedule Health Assessment in 2005 as a standard for evaluating IMS quality. The assessment measured 14 specific schedule health indicators including missing logic, leads, lags, relationship types, hard constraints, high float, negative float, high duration, invalid dates, resources, missed tasks, critical path test, Critical Path Length Index, and Baseline Execution Index.[20] The 14-Point Assessment evolved into the DCMA EVMS Compliance Metrics (DECM) framework between 2016 and 2019, expanding from 14 schedule-specific tests to over 140 metrics covering all 32 EIA-748 Guidelines—including organizational structure, work authorization, budget traceability, and indirect costs in addition to schedule health.[20][21]

Key DECM Schedule Metrics

Metric ID Name Threshold
06A202Missing Logic≤ 5%
06A204Dangling Logic≤ 5%
06A206Leads (Negative Lag)0
06A302Excessive LagFlag for review
06B102Hard Constraints≤ 5%
06B202Soft ConstraintsFlag for review
06C102High Float (>44 days)Flag for review
06C202Negative FloatTrack trend
06D102Critical Path TestCompletion moves correspondingly
06D202Critical Path Length Index (CPLI)≥ 0.95
Existing Contractual Enforcement Mechanisms

Performance Based Payments (PBP): Governed by DFARS Subpart 232.10, PBP ties contractor cash flow to objective milestone achievement. When a contractor claims a PBP event, the Administrative Contracting Officer reviews the IMS: are all predecessor tasks complete? Were any tasks completed out of sequence? Is the logic path sound? If any check fails, the event cannot be claimed.[11]

DFARS 252.242-7005 Business System Withholds: Covers six contractor business systems: Accounting, Earned Value Management, Estimating, Material Management and Accounting, Property Management, and Purchasing. A "significant" deficiency materially affects the ability to rely on reported data, persists after notification, or affects multiple contracts. Withholding: 5% for one significant deficiency, maximum 10% for two or more.[12]

EVMS Deficiency: Persistent SI-CK conformance failures could be documented as EVMS significant deficiencies under DFARS 252.234-7002, enabling withholding and creating financial incentive for compliance beyond milestone-specific PBP gates.[35]

The Sentinel-Specific Gap: These mechanisms enforce whatever the schedule contains. For Sentinel, the 2020 schedule did not contain:
• Explicit dependency between missile design maturity and silo specification
• Transition rate constraints tied to the 400-ICBM floor
• Conditional branching for integration test rework
• NC3 concurrency constraints with MMIII operations

The enforcement mechanisms were present. The content to enforce was not.
6

The 400-ICBM Floor & Transition Constraints

Section 1632 of the Fiscal Year 2026 National Defense Authorization Act permanently codified a statutory floor into Title 10 of the U.S. Code: not fewer than 400 intercontinental ballistic missiles operationally available and deployed among not fewer than 450 operational launch facilities.[13][14] This replaces temporary, uncodified minimums that had been inserted into every annual NDAA since Fiscal Year 2017.[13]

This is not policy guidance. It is law. The Secretary of Defense cannot reduce deployed ICBMs below 400, regardless of acquisition schedule status.

The Transition Constraint: 450 launch facilities minus 400 deployed missiles yields a maximum of 50 silos that can be simultaneously offline for any reason—conversion, maintenance, or construction transition.[14] Sentinel delays force extended Minuteman III operation. Every silo taken offline for conversion reduces operational inventory.

GAO-25-108466 documents the challenge: Sentinel delays require careful planning to maintain strategic deterrent during concurrent operations and extended MMIII operation.[4]

The 400-missile floor currently exists as law binding retirement decisions. It does not exist as a schedule-level constraint that rejects IMS variants proposing conversion patterns that would violate the floor. A program office could propose a conversion schedule that temporarily drops operational ICBM count below 400. Current tools would not automatically flag this as invalid. SI-CK embeds this constraint in schedule validation.

Worked Example: Constraint Violation Detection

Scenario: Q1 2031 Conversion Proposal

Given (end of Q4 2030): N_MMIII = 420, N_SENT = 0 (pre-IOC), N_ICBM = 420.

Proposed for Q1 2031: CONVERSIONS = 35, NEW_OPERATIONAL = 10.

Result: N_ICBM(Q1-2031) = (420 − 35) + (0 + 10) = 395. Below 400 floor. SI-05: FAIL.

Additionally: If 35 silos offline for conversion plus any in maintenance exceeds 50: Offline constraint violated.

Under the February 2026 restructure, new silos are built on government-owned "swing space" adjacent to operational MMIII silos.[7] The extent of available government land remains "under review."[7] Defense Explosives Safety Regulation 6055.09 and AFMAN 91-201 mandate a 1,200-foot Inhabited Building Distance standoff from operational ICBM launch facilities for construction crews.[36]

Whether construction on swing space counts against the 50-silo offline constraint is unresolved. SI-CK treats it as binding until the determination is made, consistent with SPK-07 guidance.[14]

Hard Cliff Deadlines from SPK-07

MMIII sustainment has absolute time limits that bound how late SI-CK indices can slip:[14]

CliffEarliestLatest
Propellant oldest (HTPB scenario)~2023~2030
NS-50 guidance exhaustion~2028~2035
Propellant youngest (any binder)~2034~2049

If SI-CK indices slip beyond SPK-07's "Major" threshold (>2 years from new baseline), MMIII Solid Rocket Motor replacement (PRP-2) and guidance recapitalization (NS50_RECAP) are triggered—neither of which has a program of record or funded budget line.[14]

7

SI-CK Architecture

SI-CK comprises seven components, all using mature technology at TRL 9: JSON parsing and schema validation, graph algorithms, constraint satisfaction, rule engines, linear programming, workflow engines, state machines, and append-only stores. Computational requirements are modest: input of O(104–105) tasks, graph traversal O(V+E), execution time well under one second per validation run.[19]

C1: IPMDAR Schedule Adapter

Function: Bi-directional mapping between SI-CK symbols and IPMDAR SPD structures. Each SI-CK index is defined by a mapping record specifying: a unique index_id (e.g., "IDX_SILO_GEOMETRY_LOCK_WARREN"), a descriptive name, the set of SPD TaskIDs comprising the index (task_set), a completion rule, WBS mapping codes for UC-BCK integration, and program segment assignment.[19]

Completion Rule Types:

TypeSemantics
ALL_COMPLETEAll tasks in task_set have ActualFinishDate
ANY_COMPLETEAt least one task has ActualFinishDate
WEIGHTEDWeighted average of PercentComplete ≥ threshold
EVIDENCE_GATEDTask completion plus external evidence satisfied

The adapter also detects contradictions—SPD relationships that violate SI-CK constraints, such as a successor task starting before its required predecessor completes.

C2: SI-CK Metrics (SI-01 through SI-07)

SI-CK adds seven program-specific metrics to the DECM framework:

SI-01

Design-Infrastructure Sequencing

IDX_MISSILE_DESIGN_FREEZE must have FS successor to all IDX_SILO_GEOMETRY_LOCK_*

MANDATORY

SI-02

Easement-Construction Sequencing

Each IDX_EASEMENT_ACQUIRED_[X] must have FS successor to IDX_CABLE_CORRIDOR_CONSTR_START_[X]

MANDATORY

SI-03

NC3 Alert Floor Compliance

IDX_NC3_FIBER_OVERLAY_* cannot start unless IDX_MMIII_ALERT_FLOOR_MET_* = true

PER D_min

SI-04

Rework Branch Coverage

All IDX_*_TEST nodes must have at least one conditional successor path

MANDATORY

SI-05

Conversion Rate Compliance

Offline_silos(t) ≤ 50 and N_ICBM(t) ≥ 400 for all t

PER FORMULA

SI-06

Index Mapping Completeness

All SENTINEL_INDEX_LIBRARY indices mapped to SPD task_sets

100%

SI-07

Cross-Index Consistency

No TaskRelationships contradict COUPLING_MATRIX

0 VIOLATIONS

C3: Sentinel Index Library — Five Categories

The Sentinel Index Library is the canonical list of lifecycle milestones and dependency templates, organized in five categories:

Category 1: Missile System (MISSILE_SYS): Requirements locked → PDR → CDR → Design Freeze → Stage 1/2/3 Motor Qualification, PBV Qualification, Guidance Qualification → First Flight Test → Flight Test Series Complete. All qualification indices depend on Design Freeze; First Flight Test depends on all qualification indices.

Category 2: Ground Infrastructure (GROUND_SYS) — Per Wing: For each wing (Warren, Malmstrom, Minot): Silo Geometry Lock, LCC Design Lock, and MAF Design Lock all depend on IDX_MISSILE_DESIGN_FREEZE. Per corridor/segment: Easement Acquired → Environmental Cleared → Cable Corridor Construction Start → Construction Complete. Per facility: Construction → Outfitting → Ready. Easement indices are decomposed to segment level because a single holdout parcel blocks an entire corridor path.[36]

Seasonal Binding (from SPK-03): Ground infrastructure indices are bounded by construction season windows: Warren (May 1 – Nov 15, 6.5 months), Malmstrom (May 1 – Oct 31, 6 months), Minot (May 15 – Oct 15, 5 months). Mud-season logistics blackouts (March 1 – mid-May) further constrain material delivery.[36]

Category 3: NC3 Integration (NC3_INTERFACE): Architecture Locked → Fiber Overlay per wing/segment (requires cable corridor complete + MMIII alert floor met) → Integration Test phases → NC3 Certification.

Category 4: Warhead Integration (WARHEAD_SYS): MMIII Decommission per batch → W87-0 Warhead Harvest → Warhead Handoff → Sentinel Armed. W87-1 availability is an external DOE/NNSA dependency.

Category 5: Transition and Operations (TRANSITION): MMIII Alert Floor per wing/period, Silo Conversion per silo ID, Wing IOC/FOC per wing, System IOC (first wing), System FOC (all wings).

C4–C7: Coupling Matrix, Transition Module, Enforcement, Evidence Ledger

C4: Extended Coupling Matrix Engine. For non-test dependencies, the coupling matrix is a precedence relation: M[a,b] = 1 implies index b cannot complete until index a completes, encoded as RelationshipTypeID = 1 (FS) with lag ≥ 0. For test indices, SI-CK requires explicit conditional branches per the JA CSRUH methodology[22]: outcomes include PASS (proceed), FAIL_MINOR (rework and retest), FAIL_MAJOR (design revision, rework, retest). For ground infrastructure, SI-CK requires contamination/cultural resource discovery branches: SPK-03 documents a 10–20% discovery rate per site, yielding 45–90 expected events across 450 sites—a near-certainty at program level.[36]

C5: Transition Rate Constraint Module. Formal specification: N_ICBM(t) = N_MMIII(t) + N_SENT(t) ≥ 400 for all t. LF_active(t) ≥ 450. Offline_silos(t) ≤ 50. D_min = 400 (statutory floor per FY26 NDAA Section 1632).[13] Physical production rate ceiling from SPK-03: at the most constrained wing (Minot, 91st MW), effective construction capacity is approximately 14–18% of nominal after weather, logistics, productivity, travel, and security multipliers compound.[36]

C6: Enforcement Integration Layer. Status is derived from SPD data and evidence conditions, not asserted. Manual overrides require authenticated identity, justification, and approval. Governance integration: IMS Baseline Acceptance (blocking), Major Re-Plan Approval (blocking for SI-05), PBP Event Claim (blocking via PBP logic), NOC Review (advisory with escalation), SAR Schedule Section (data source).

C7: Evidence Ledger. Records all validation runs, results, overrides, and adjudications. Entries include SPD hash, SI-CK specification version, per-metric results, and attribution. Any authorized party can replay a historical validation by retrieving the archived SPD and re-executing against the logged specification version. This enables GAO, CAPE, or Congressional staff to independently verify conformance status.

8

Governance & Implementation

Governance Integration

Nuclear Oversight Committee (NOC): Established in Fall 2023—before the formal January 2024 Nunn-McCurdy breach notification—as a proactive step to address emerging Sentinel challenges. Co-chaired by the most senior leaders of the Department of the Air Force, overseeing the nuclear enterprise including strategic bombers, land-based ICBMs, and nuclear command and control.[15][37] SI-CK conformance reports flow to the NOC; SI-05 (D_min) failure cannot be approved without resolution.

Program Executive Officer for ICBMs (PEO ICBMs): The Air Force established a dedicated PEO for ICBMs at the Air Force Nuclear Weapons Center, serving as the portfolio owner for both Minuteman III and Sentinel programs.[16] PEO ICBMs is the functional owner of SI-CK—maintaining the Sentinel Index Library, defining conformance criteria, ensuring CDRL inclusion, exercising waiver authority for non-critical violations, and escalating unresolved critical violations to NOC.

Air Force Nuclear Weapons Center (AFNWC): AFNWC at Kirtland AFB remains the institutional host for nuclear acquisition and sustainment, including the ICBM Systems Directorate at Hill AFB.[17] Note: a 2024 proposal to restructure AFNWC into a 3-star "Air Force Nuclear Systems Center" was canceled in December 2025 as part of the rollback of major portions of the Re-Optimization for Great Power Competition initiative.[38]

Cross-Spoke Integration

UC-BCK (SPK-01): Schedule indices connect to cost metrics through shared WBS codes (MIL-STD-881F) and common program segment definitions (MISSILE_SYS, GROUND_SYS, NC3_INTERFACE). When SI-CK detects schedule slip, UC-BCK computes marching army costs—Level of Effort activities that continue burning budget during delay. When UC-BCK computes a Nunn-McCurdy breach, SI-CK provides the schedule decomposition: which indices are delayed, which segments have slip.

GI-PCK (SPK-03): Physical constraints bound SI-CK's ground infrastructure indices: construction season windows (5–6.5 months by wing), mud-season blackouts (9–10.5 weeks), cold-weather productivity degradation (10–95%), clearance pipeline throughput (5–12 months; GAO-26-108838[39]), seasonal workforce dissolution, linear network vulnerability, and the compounding cascade (14–18% effective capacity at Minot).[36]

Implementation Roadmap

Phase 0 (Months 1–6): Specification and Policy. Draft SI-CK Conformance Specification. Define complete Sentinel Index Library with PEO ICBMs input. Establish dependency templates based on Nunn-McCurdy root cause findings. Obtain policy authorization.
Phase 1 (Months 7–12): Validator Development. Implement IPMDAR Schedule Adapter, DCMA Metric Integration with SI-CK-specific metrics, Coupling Matrix Engine with conditional branching, Transition Rate Constraint Module, Evidence Ledger, UC-BCK integration interfaces.
Phase 2 (Months 13–24): Pre-Baseline Engagement. Provide SI-CK specification to prime contractor during IMS development. Conduct iterative conformance checks. Integrate SI-CK validation into Milestone B review criteria.
Phase 3 (Months 25–36): Operational Deployment. Continuous validation of Sentinel IMS updates. Integration with NOC review cycle. Update production function calibration with demonstrated rates from Promontory prototype and Warren corridor prototype.
Critical Window: SI-CK must be established before the new IMS is built. Milestone B re-certification is expected end of 2026.[8] The specification must be completed and accepted during the restructuring period. Once a new baseline is established without SI-CK conformance requirements, the opportunity closes until the next breach.
What SI-CK Does Not Achieve: SI-CK cannot prevent technical failures, funding instability, or requirements changes. It ensures that whatever happens is measured consistently, attributed accurately, and propagated correctly through the dependency network. It cannot manufacture feasibility from insufficient resources. If the program’s timeline is infeasible given the physical constraints documented in SPK-03, SI-CK will demonstrate that infeasibility.

Acceptance Criteria

SI-CK must satisfy eight acceptance criteria to close the identified gaps. All remain unmet as of the current date.

AC-1 (MC2)
Schedule status for every Sentinel milestone derives algorithmically from IPMDAR SPD task completion states, not narrative assertion.
● UNMET
AC-2 (PE2)
All schedule assertions reduce to index shifts and gate completion in the Sentinel Index Library with traceable logical predecessors.
● UNMET
AC-3 (SI-06)
The Sentinel Index Library maps 100% of program milestones to SPD task_sets across all five categories.
● UNMET
AC-4 (SI-01)
The Coupling Matrix encodes all physical dependencies including design-infrastructure sequencing (missile design freeze → silo geometry lock).
● UNMET
AC-5 (SI-05)
The Transition Rate Constraint Module enforces the 400-ICBM statutory floor and 50-silo offline cap at schedule validation level.
● UNMET
AC-6 (SI-04)
All test indices have explicit conditional branching for rework sequences (PASS / FAIL_MINOR / FAIL_MAJOR) per JA CSRUH methodology.
● UNMET
AC-7 (C7)
The Evidence Ledger enables independent replay of any historical validation by GAO, CAPE, or Congressional staff using archived SPD and logged specification version.
● UNMET
AC-8
SI-CK specification is completed and accepted before the new Milestone B baseline is established (expected end of 2026).
● UNMET

Sources

  1. [1] U.S. Department of Defense. "Department of Defense Announces Results of Sentinel Nunn-McCurdy Review." July 8, 2024. defense.gov
  2. [2] GAO-26-108755, "National Security Snapshot: Intercontinental Ballistic Missile Modernization Faces Critical Risks." February 18, 2026. gao.gov
  3. [3] Arms Control Association. "Sentinel ICBM Exceeds Projected Cost by 37 Percent." March 2024. armscontrol.org
  4. [4] GAO-25-108466, "ICBM Modernization: Air Force Actions Needed to Expeditiously Address Critical Risks to Sentinel Transition." 2025. gao.gov
  5. [5] AFNWC. "Department of Defense announces results of Sentinel Nunn-McCurdy Review." July 2024. afnwc.af.mil
  6. [6] Decker, A. "Sentinel nuclear missiles will need new silos, Air Force says." Defense News, May 2025. defensenews.com
  7. [7] Gordon, C. "Sentinel ICBM Restructure to Bring 'More Capability Faster.'" Air & Space Forces Magazine, February 28, 2026. airandspaceforces.com
  8. [8] Marrow, M. "EXCLUSIVE: Sentinel ICBM to clear key review this year, go operational in early 2030s." Breaking Defense, February 2026. breakingdefense.com
  9. [9] Humphreys & Associates. "IPMDAR — DI-MGMT-81861C." humphreys-assoc.com
  10. [10] Ten Six Consulting. "What is the DCMA 14-Point Assessment?" tensix.com — Deltek Acumen. "DECM Metrics." deltek.com
  11. [11] DFARS Subpart 232.10, "Performance-Based Payments." acq.osd.mil
  12. [12] DFARS 252.242-7005, "Contractor Business Systems." acquisition.gov
  13. [13] FAS. "What's New for Nukes in the New NDAA?" December 2025. fas.org — Fischer, D. "Fischer Strengthens Nuclear Deterrence in FY2026 NDAA." July 2025. fischer.senate.gov
  14. [14] SPK-07 (WST-K) v2.0 locked parameters. Sentinel Recovery Architecture internal document.
  15. [15] DoD Press Briefing. Transcript, July 2024. defense.gov — Air & Space Forces Magazine. "Sentinel ICBM Survives Pentagon Review, But Cost Jumps 81%." July 2024. airandspaceforces.com
  16. [16] DVIDS/AFNWC. "Air Force established new PEO for ICBMs at Nuclear Weapons Center." dvidshub.net
  17. [17] Air Force Nuclear Weapons Center. afnwc.af.mil
  18. [18] OUSD(A&S). "Transitioning to IPMDAR." acq.osd.mil — DI-MGMT-81861C: quicksearch.dla.mil
  19. [19] OUSD(A&S). IPMDAR SPD Data Exchange Instructions v1.0. DEI — File Format Specification v1.0. FFS
  20. [20] SmartPM. "The DCMA 14 Checks." smartpm.com — DCMA EVMS Metrics v8.0. dcma.mil
  21. [21] SNA Software. "News & Events" (DECM v8.0). sna-software.com — Pinnacle Management. "DECM v8.0: A Strategic Shift." pinnaclemanagement.com
  22. [22] Naval Center for Cost Analysis / Air Force Cost Analysis Agency. Joint Agency Cost Schedule Risk and Uncertainty Handbook (JA CSRUH). March 2014, updated September 16, 2014. ncca.navy.mil
  23. [23] GAO-14-322, "F-35: Problems Completing Software Testing." March 2014. gao.gov
  24. [24] GAO-15-364, "F-35: Assessment Needed to Address Affordability Challenges." April 2015. gao.gov
  25. [25] GAO-21-105282, "F-35: Cost and Schedule Risks in Modernization Program." July 2021. gao.gov — GAO-21-226. gao.gov
  26. [26] GAO-12-366, "KC-46 Tanker: Acquisition Plans Have Good Features but Contain Schedule Risk." March 2012. gao.gov
  27. [27] GAO-15-308, "KC-46: Key Aerial Refueling Capabilities Should Be Demonstrated Prior to Production Decision." April 2015. gao.gov
  28. [28] GAO-19-480, "KC-46: Aircraft Delivery Has Begun, but Deficiencies Could Affect Operations." June 2019. gao.gov
  29. [29] U.S. Department of Defense. Contract Announcement, September 8, 2020. defense.gov
  30. [30] U.S. Air Force. "Department of the Air Force awards contract for new ICBM system." September 8, 2020. af.mil
  31. [31] Air & Space Forces Magazine. "New ICBM Has Critical Cost, Schedule Overruns." January 2024. airandspaceforces.com
  32. [32] U.S. Strategic Command. "Delivering deterrence: Sentinel restructure to complete in 2026." February 2026. stratcom.mil
  33. [33] FAS. "Saving Billions on the US Nuclear Deterrent." April 2024. fas.org
  34. [34] OUSD(A&S). IPMDAR Implementation and Tailoring Guide. acq.osd.mil
  35. [35] DFARS 252.234-7002, "Earned Value Management System." acquisition.gov — DFARS 252.234-7003. ecfr.gov
  36. [36] SPK-03 (GI-PCK) v2.0. Sentinel Recovery Architecture. Construction season windows, mud-season logistics, cold-weather productivity, clearance pipeline, seasonal workforce, linear network vulnerability, compounding cascade, contamination discovery rates, nuclear surety standoff.
  37. [37] National Defense Magazine. "Defense Department Says No Alternative to Troubled ICBM Program." July 8, 2024. nationaldefensemagazine.org
  38. [38] Air & Space Forces Magazine. "USAF's 'Re-Optimization': Top Leaders Rule on What's In, What's Out." December 2025. airandspaceforces.com
  39. [39] GAO-26-108838, "Personnel Vetting: Leadership Attention Needed." February 24, 2026. gao.gov
